Project challenges

In 2015, urbanism service in the city of Rochefort

limited maximum construction height to 15 m. With this

limitation, the parallel piped flat silo was designed and

adopted to replace the normal cylinder silo. From field

investigation, scheme development, discussion, and plan

adjustment, through to final confirmation, the silo spent

a total of six months with tight collaboration between

several parties, ultimately conquering the difficulty in silo

shape.

The final plan was to erect two 2450 m

3

metallic cells

next to each other. The unique structure required a 600 m

2

concrete slab to be poured as a foundation. Each foot of

the silo was attached to a concrete block of about 10 m

3

,

which itself rested on between one and three metal piles of

30 m, in order to reach the hard rock under the surface. In

total, 100 piles were used to ensure 6500 t of cement could

be held when the silo was full.

High efficiency and a green white cement

terminal

The construction of terminal foundations started in

August 2016 and lasted for three months. Assembly of

the “huge Meccano” began in December 2016, with 24

bottoms that collect cement. This project was completed

in the middle of 2017. During the same period CCI,

the public administration of the port, installed the

underground pipeline, which connects the shore to the

silo at a 70 m distance.

Up to 3800 t of cement could be loaded from either

traditional bulk carriers or self-unloading vessels to a

cement silo, via an underground pipeline.

A self-discharging vessel could deliver its 3500 t of white

cement in 20 – 22 hours without stopping.

In order to load trucks, the station is fed by two vertical

screws, each of which collects cement from Silo 1 or Silo 2,

via three horizontal screw conveyors placed under each silo.

Thus, the loading of a 30 t cement tank could be completed

in less than 20 min. The aim of the vertical screws is to

convey large quantities of cement, with the purpose of

space saving, easy maintenance, and being pollution free.

High-pressure dense-phase pneumatic conveying

systems are the key technique used to transfer white

cement from ship to silo. To keep a green and dustless

loading process, three air extraction machines pump

6000 m

3

/hour of cement, with inside dust filters, are

installed on top of the two silos. This system successfully

filters out 99.9% of dust.

Unlike grey cement, colour is the most crucial quality

index of a white cement product. This strict quality control

is managed by the Aalborg Cement Quality Center. White

cement quality, including its white colour, is monitored

and controlled in the Aalborg plant throughout the whole

production process. A cement sample is taken to the boat

for conformance testing before being shipped to the

Rochefort Terminal. The cement pipeline is dedicated to

white cement product conveying, meaning there is no risk

of cross pollution. A sample survey of each silo is required

four times each year by the Aalborg Cement Quality Centre

to ensure cement quality.

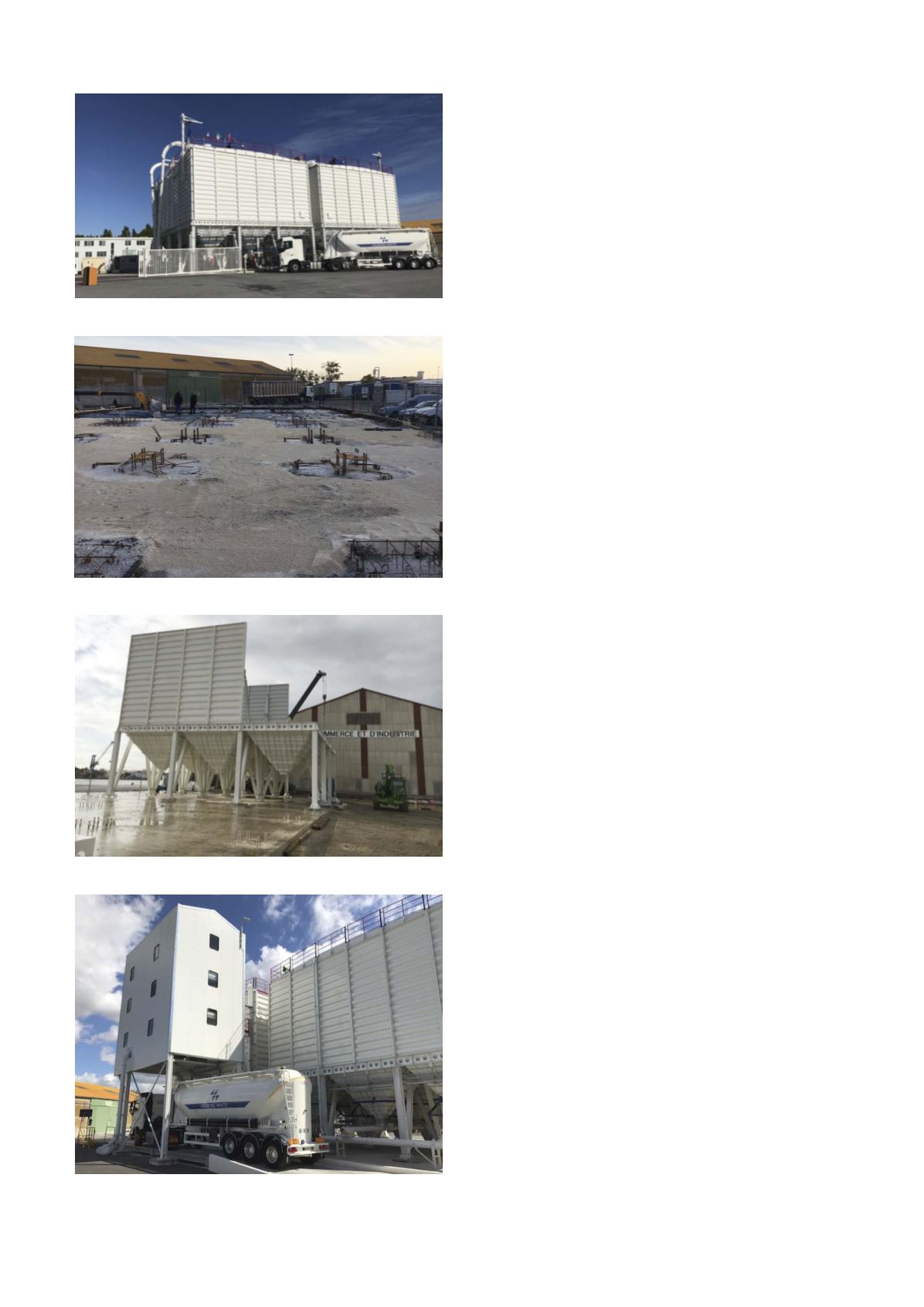

Aalborg White Terminal in Rochefort, France.

Installation of cement silos.

A safe and reliable automated operation system on

truck loading.

Construction of terminal foundations.
